Line integration

Packaging Line Integration

Packaging line integration explained: what it covers, who owns it, how mechanical, controls, safety, and FAT/SAT scope fit, and how to choose an approach.

On this page
  1. What packaging line integration is, and who it is for
  2. Who owns integration
  3. The integration scope
  4. Mechanical handoffs
  5. Controls and communication
  6. Safety zones
  7. Documentation
  8. FAT and SAT
  9. Single-source or multi-vendor
  10. How integration connects to design and layout
  11. Decision factors
  12. Where to go next
  13. Common mistakes

A packaging line is a set of machines that each do one job well: filling, capping, labeling, case packing, palletizing, wrapping. Integration turns them into a line. It decides how product moves from one machine to the next, how the machines tell each other what they are doing, how people stay safe around all of them at once, and how everyone proves, before and after delivery, that the whole thing runs at the rate the business needs.

The sections below cover what integration includes, who can own it, and how to choose between buying from one source and assembling the line from several suppliers. Two deeper pages, on turnkey lines and on line design, pick up where this one stops. A third page covers packaging line layout.

What packaging line integration is, and who it is for

Most packaging machines are designed and tested alone. A case packer is rated on cases per minute at its own infeed. A palletizer is rated on its own cycle. Neither rating says what happens when product arrives in bursts from upstream, when a downstream machine stops for a film change, or when two machines disagree about who should wait for whom. Integration answers those questions before the line is in production, not during its first week.

Three groups care most. Plant and packaging engineers need to specify and accept a line. Operations managers need a line that runs without constant minor stops and without finger pointing. Procurement teams need a contract with no gaps in scope. A new line, a major expansion, and a retrofit that adds a machine to an existing line all raise the same questions, though the effort differs.

Integration is not the same as machine selection. You can choose excellent machines and still get a poor line if the interfaces are vague. The reverse also holds: a modest set of machines with clean handoffs, sensible buffers, and agreed controls often outperforms a more impressive set that was never designed to work together.

Who owns integration

Every line has an integrator, whether or not anyone uses the word. The question is who. There are four common arrangements.

  1. The plant’s own engineering team. The plant buys machines separately, writes the interface requirements, coordinates the schedule, and does the testing. This gives the most control and the most freedom to change suppliers, and it puts the most risk and work on the plant.
  2. A lead machine supplier. One supplier, often the one providing the central machine, coordinates the others. The scope can be narrow, such as only the conveyors around its own machine, or broad enough to resemble a turnkey project.
  3. An independent system integrator. This party may build little or no equipment. It designs the line, selects or specifies machines, writes the controls, and manages testing, and it is paid for engineering and accountability, not for hardware margin.
  4. A turnkey supplier. One contract covers the equipment, interfaces, controls, installation, and acceptance. The turnkey packaging line page covers what that means in practice and where it fits poorly.

None of these is automatically better. What matters is that the owner of each interface is named in writing. To test this, pick any boundary on the line, such as the transfer between a case sealer and a palletizer infeed, and ask who is responsible if it jams, who is responsible if the signals do not match, and who pays to fix it. If the answer is unclear, the integration scope has a gap.

The integration scope

Integration scope divides into five areas, and a written scope should say who is responsible for each.

Mechanical handoffs

A mechanical handoff is any point where product leaves one machine and enters another: transfers between conveyors, the join between one machine’s discharge and the next machine’s infeed, and the guides, side rails, and transfer plates in between. The usual trouble spots are height, speed matching, product orientation, and gap control.

Handoffs differ by package. Upright bottles can tip at an unsupported transfer. Soft-sided cases can snag. Bags can slide. A handoff that works at low speed may fail at the line’s rated rate, which is why the bottle conveyors and case conveyors pages treat transfers as a design topic of their own. Between machines running at different speeds, buffers and accumulation conveyors absorb the difference and let product queue without damage.

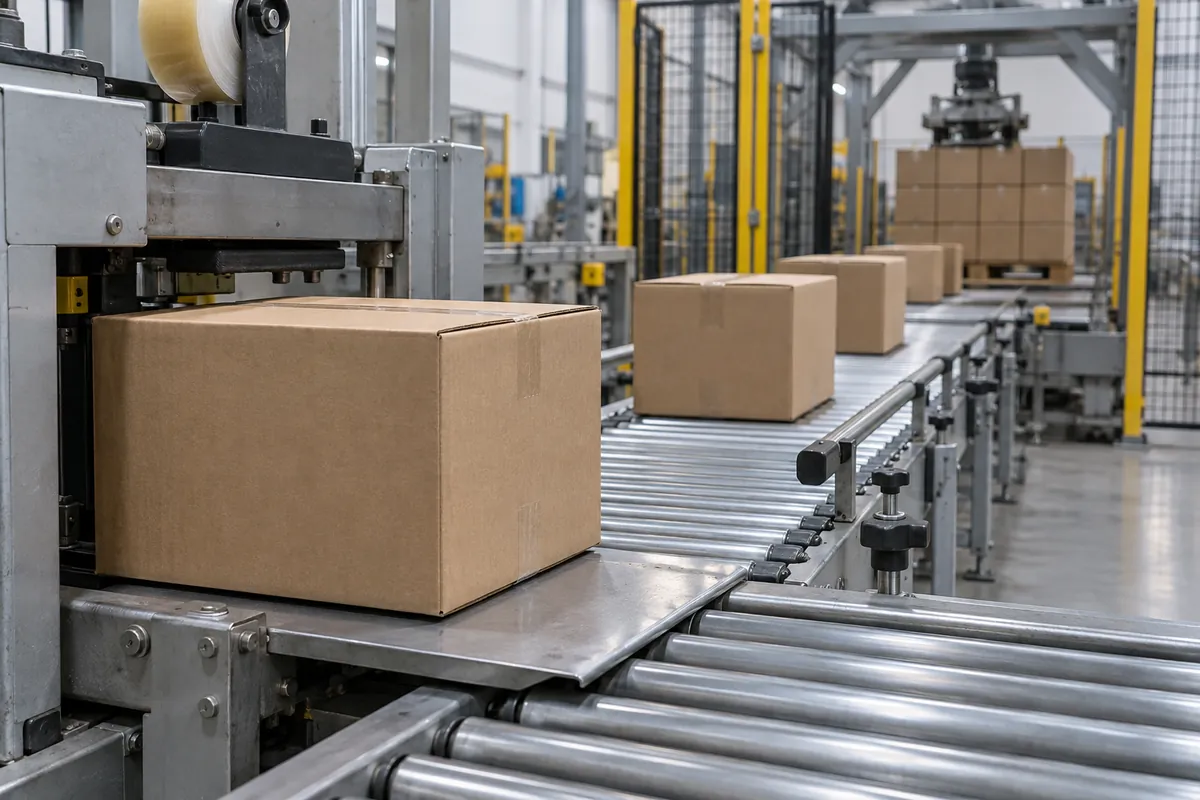

Cases moving from a case sealer discharge across a transfer plate onto a roller conveyor leading to a palletizer infeed, with guard rails on both sides
Illustrative image: a mechanical handoff between a case sealer and conveying toward a palletizer.

Controls and communication

At the simplest level, controls integration is a set of start permissions, ready signals, fault signals, and accumulation sensors wired between machines. At a higher level it adds a line controller, a supervisory system, shared alarms, recipe or format change commands, and data collection for production reporting.

PackML is a useful standard here. It is a machine state model for packaging equipment, published as ISA-TR88.00.02 and developed by the OMAC packaging work group. It defines a common set of machine states, such as Idle, Execute, Held, Suspended, and Aborted, plus operating modes and standard data tags. Describing states the same way on every machine makes a mixed-vendor line easier to operate, and makes counts and downtime data easier to compare. It does not make two machines compatible by itself, since the signals and sequences between them still have to be specified. The standard is an implementation example built on the ISA-88 family of terms, and its latest edition dates from 2022.

Controls scope should also list the physical network, the protocols each machine supports, who owns the line controller program, who may change it after handover, and how remote support works. Ownership of the source code is a contractual question, and it is easiest to settle before the project starts.

Safety zones

Each machine arrives with its own guarding and safety system. Once the machines are joined, the safety design has to cover the whole line. Where does one safety zone end and the next begin? If an operator opens a gate on one machine, what must stop and what may keep running? When a conveyor passes through a guard fence, how is the opening protected? Emergency stops, light curtains, interlocked doors, and restart procedures all have to be consistent across the line, and whoever sets up lockout points must see one coherent picture.

The normal way to find these gaps is a single risk assessment of the finished line, rather than a collection of per-machine assessments. The page on automation in end-of-line packaging discusses guarding for robot cells and conveyor crossings in more detail.

Documentation

Documentation is where integration often disappoints. A line with ten suppliers can arrive with ten styles of electrical drawing, ten manual formats, and no document that describes the line as a whole. A good scope asks for a line-level package: an overall layout, one set of electrical and network drawings or an index tying them together, a signal list for every interface, a software description, spare parts lists, and a maintenance plan. It should also ask for as-built drawings, since drawings that match the design but not the installed machine are worse than none.

FAT and SAT

Acceptance testing turns scope into evidence. A factory acceptance test (FAT) happens at the supplier’s plant before shipment. A site acceptance test (SAT) happens in your building, with your utilities, your product, and your operators. Both should trace back to written requirements, use representative product, and have pass criteria agreed before the test, not argued during it. Open items need an owner and a route to closure. One practical guide splits the work into three groups: checks that can be proven before the equipment ships, checks that belong to installation, and checks that only the live production environment can confirm.

The commissioning and acceptance checklist lists the points a written FAT protocol should state, including run duration, target rate, product list, changeovers, fault recovery, and safety device checks.

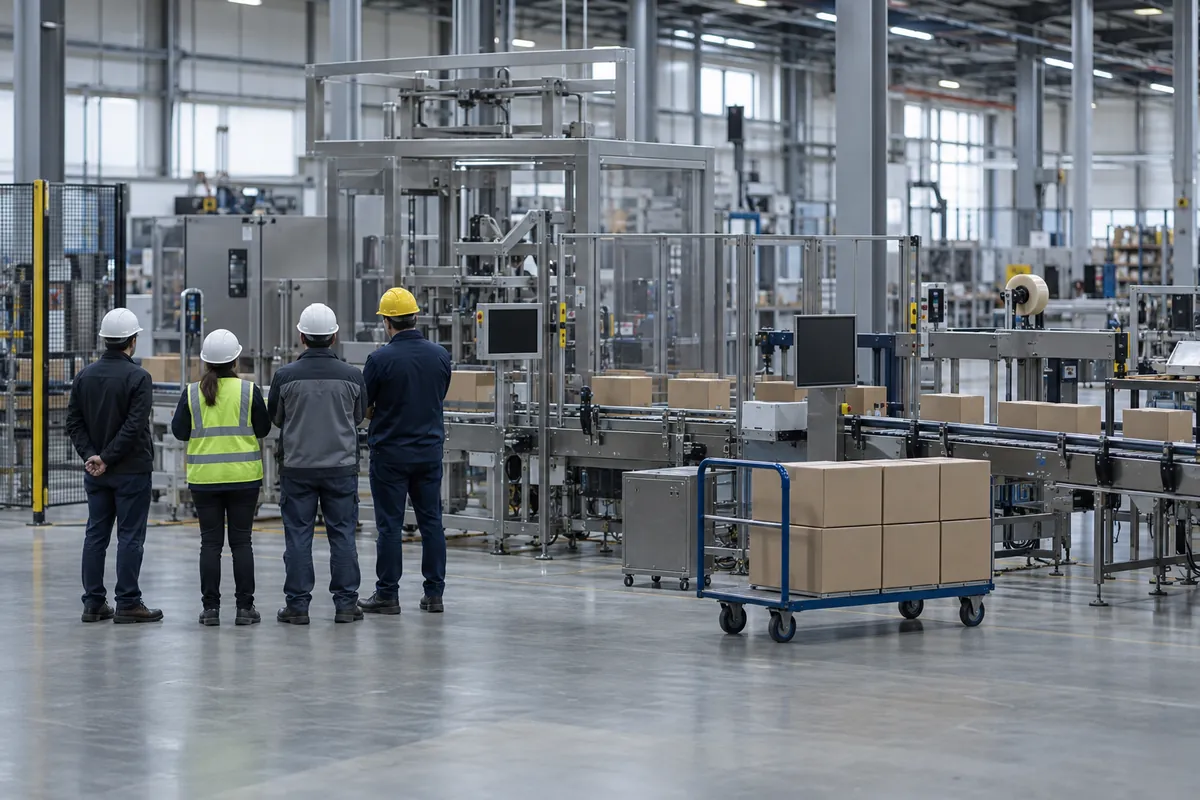

Engineers and operators seen from behind watching an integrated line run during a factory acceptance test on a shop floor
Illustrative image: a factory acceptance test of an integrated line on a shop floor.

Single-source or multi-vendor

The central decision is how many parties should own parts of the line. Both approaches work, and they shift effort and risk in different ways.

Factor Single source Multi-vendor
Interface accountability One party answers for the combined line The plant or an integrator must assign and enforce it
Machine choice Limited to what the supplier offers or buys in Best machine for each job
Engineering effort for the plant Lower; mostly requirements and acceptance Higher; interface specifications, scheduling, testing
Controls One program and one documentation style Several platforms that must be tied together
Flexibility to change later Depends on the supplier’s openness Easier to replace a single machine
Schedule risk One schedule to manage Dependencies across suppliers
Negotiating position One large contract More competition per machine, less bargaining power over the whole

Single-source delivery suits plants that want to buy a result rather than a project, that lack spare controls engineering capacity, or that run a standard line type. It can be a poor fit when the line includes unusual machines one supplier cannot provide, when the plant has strong preferences on controls platform, or when the plant expects to keep changing the line.

Multi-vendor delivery suits plants with capable engineering teams, a clear picture of what they want from each machine, and a willingness to write interface specifications. It is more work, and it only holds together when someone owns the whole.

Hybrids are common. A plant may buy the filling and capping machines from the process equipment suppliers it trusts, and give one supplier the whole end-of-line section, from case packing through palletizing. The line is then two integrated blocks joined at one clearly defined interface.

How integration connects to design and layout

Integration scope is set after the line has been designed, and the design depends on integration choices. The line design page covers the engineering sequence: requirements, rates, machine selection, buffers, changeovers, and utilities. The layout page covers where machines sit in the building, and the packaging line layout guide gives a decision-oriented summary. Integration runs across all three, because it defines the interfaces those decisions create.

One concept links design to integration: the machine with the lowest capacity sets the pace of the line. Machines before it need spare capacity to refill the buffer after a stop, and machines after it need spare capacity to clear product that has piled up. This speed profile is often called the V-curve. It is a starting point, not a complete method, and the line design page covers its limits.

Decision factors

Six questions shape the approach for a specific project.

How many suppliers will be involved? The more parties, the more the interface list matters, and the more a single point of accountability is worth. How much controls engineering can the plant provide? A plant with a strong controls team can take on more of the work.

Is it a new line or a retrofit? Retrofits must work around existing machines, controls, and floor space, which often favors a scope the plant controls closely. What happens after handover? A plant that will modify the line often needs the program source and drawings.

How sensitive is the product? Food, beverage, and pharmaceutical lines add sanitation and validation requirements that affect what documentation the line needs. And what does downtime cost? A line that feeds a shipping deadline justifies more rigorous acceptance testing.

Where to go next

For a complete line from one supplier, read the turnkey packaging line page. For the engineering side, read packaging line design. For equipment at the end of the line, see end-of-line packaging, case packers, and robotic palletizers. The beverage packaging and food packaging pages show how the same integration questions play out in each sector. To weigh equipment cost, see the palletizer cost guide and the conveyor cost guide.

Common mistakes

  • Buying machines before defining interfaces. The signal list and transfer heights should exist before purchase orders do.
  • Treating each machine’s rated speed as the line speed. The slowest machine sets the line rate, along with how well buffers and stops are managed.
  • No owner for the combined safety assessment. Each supplier certifies its own machine, and nobody examines the gaps between them.
  • Accepting machines individually and the line never. Individual FATs are useful, but only a combined test shows how the line behaves.
  • Leaving documentation to the end. Drawings and manuals are cheapest to get right when they are requested in the purchase contract.
  • Ignoring people. Operators and maintenance staff need training on the line as a system, not just on each machine.

In this section

  • Turnkey lines

    What a turnkey packaging line means in a contract and in engineering: scope, the URS, project phases, acceptance testing, risk allocation, and poor fits.

  • Line design

    How packaging line design works: from requirements to rates and machine selection, the V-curve, accumulation, changeover strategy, utilities, and human factors.

  • Line layout

    Principles for packaging line layout: straight, L, U, and serpentine shapes, material and people flow, access, clearances, forklift paths, and safety zoning.

  • Commissioning

    How to commission a packaging machine or line: purchase terms, factory acceptance test, site acceptance test, handover documents, and a printable checklist.

Frequently asked questions

What does a packaging line integrator actually do?

An integrator takes responsibility for how machines work together. That usually means defining the interfaces between them, designing or coordinating the line controls, specifying conveyors and buffers, managing the safety design across machine boundaries, running acceptance tests on the combined line, and delivering one set of documentation. The exact duties depend on the contract, so the scope must be written down.

Is a system integrator the same as a machine builder?

Not always. A machine builder makes one or more machines. An integrator may build some equipment, but its distinguishing job is making machines from several sources work as a line. Some suppliers do both, and some integrators build nothing themselves and buy everything in.

Can I integrate a line myself with machines from different suppliers?

Yes, if your team has the controls, safety, and project management capacity and accepts that the interface risk is yours. The risks are finger pointing when the combined line misses its rate and uneven documentation. Plants that do it well write interface specifications first and hold every supplier to them.

What is the difference between FAT and SAT?

A factory acceptance test checks equipment at the supplier's plant before shipment, ideally with your product or close representatives. A site acceptance test checks the installed line in your building, with your utilities, materials, and operators. Both should use the same core performance criteria so results can be compared.

Do all machines on a line need to use the same control platform?

No. Machines from different suppliers often use different controllers. What matters is a defined interface: the signals, data, and state behavior each machine exposes. A common machine state model such as PackML can make mixed lines easier to operate and monitor.
